Implementation

ESTRO has been structured in 2 technical work-packages and a WP dedicated to Project Management, Dissemination and Exploitation activities. In order to organise activities the work-packages are broken down in different tasks. The Work- Package breakdown structure, at task level, is shown in the figure below, together with a schematic representation of inter-dependencies.

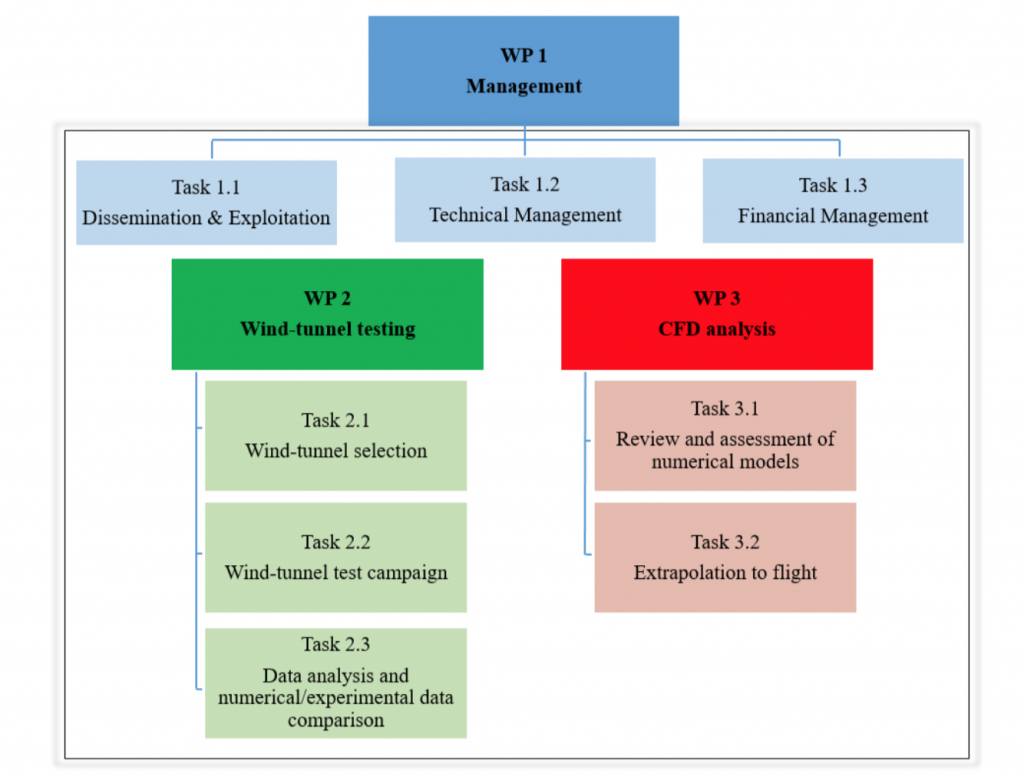

Work-Breakdown Structure of ESTRO

The scheduling of the different activities in the project can be better is shown in details in GANTT chart

The table below lists the main milestones of ESTRO, with the responsible applicant, the time line and the reference WP. Indeed, deliverables are listed in the tables corresponding to each WP.

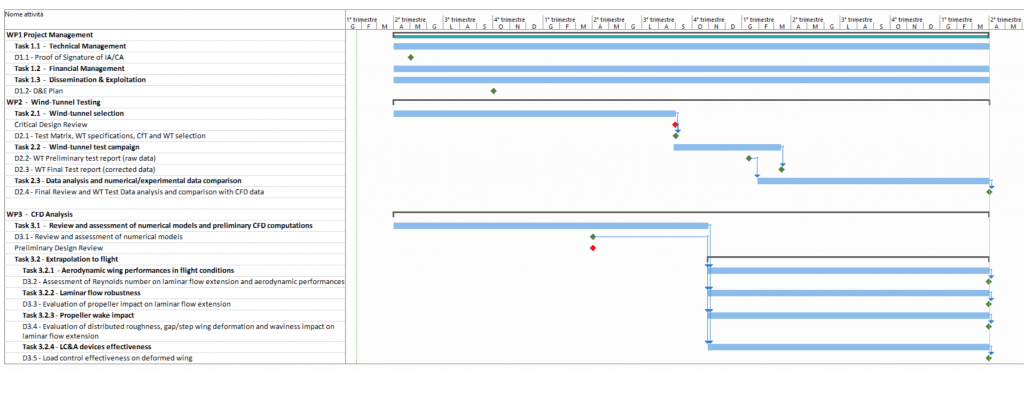

ESTRO GANTT Chart
Table of Milestones
